Vietnam Wooden Kitchenware Lead Times and Peak-Season Capacity: Planning Q4 2026 and the Tet 2027 Shutdown

Most wooden kitchenware orders that arrive late were never actually late in production. They were booked against a lead time that only described the factory floor, while the weeks that really decided the delivery date sat outside it: lumber procurement, kiln drying, artwork approval, inspection scheduling, and a vessel booking made three weeks too close to departure.

This guide sets out how the calendar genuinely works for Vietnamese wooden kitchenware and houseware production in 2026, why the middle of August is the last comfortable decision point for Q4 retail and early 2027 programmes, and how the Lunar New Year shutdown in February 2027 quietly removes almost six weeks of usable capacity from the first quarter.

It is written for procurement managers, importers and private-label buyers who need a date they can put in front of their own customers and defend.

What a Quoted Lead Time on a Vietnamese Quotation Actually Covers

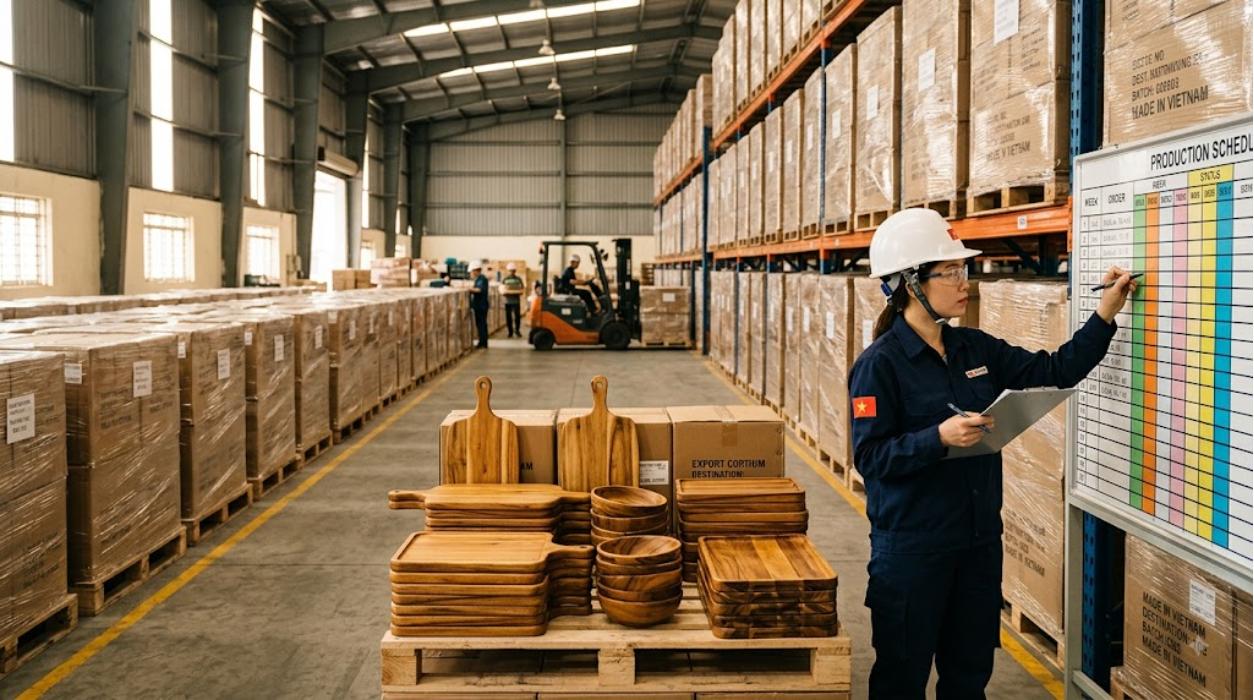

Production planner updating a weekly production schedule board in the finished-goods dispatch warehouse of a Vietnamese wooden kitchenware factory, with stacked acacia cutting boards, bowls and trays on a pallet beside labelled export cartons
Peak-season dispatch planning at a Vietnamese wooden kitchenware and houseware factory.

When a Vietnamese factory writes 45 days on a proforma invoice, that figure normally means calendar days from confirmed deposit and approved artwork to goods ready at the factory gate. It is not days from your purchase order, and it is not days to the port of loading. Three things routinely sit outside it.

  • Material acquisition. The factory buys lumber against confirmed orders, not on speculation. For acacia and rubberwood this is a real procurement step with its own queue, particularly for wide, defect-free stock used in serving boards.
  • Kiln drying. Sawn timber does not enter machining until it is stabilised. This is a fixed physical process that cannot be compressed by paying more.
  • Approvals held by the buyer. Artwork, laser-engraving files, packaging dielines, barcode data and the signed pre-production sample. Every day a factory waits for these is a day added to the back end, not absorbed.

The practical fix is to ask every supplier to quote lead time in two parts: days from deposit to goods ready, and days from goods ready to on-board vessel. A supplier who cannot separate the two is quoting from habit rather than from a schedule.

The Real Calendar: Where the Weeks Actually Go

For a first order of one 40ft high-cube container of mixed acacia cutting boards, bowls and serving trays, a realistic Vietnamese schedule in normal season looks like this. Repeat orders of an already-approved SKU remove the sampling block entirely.

  • Sampling and approval: 10 to 15 days. Two to three days for the first sample once the specification is clear, then shipping time to you, then your review. Courier time to the Gulf is three to five days, to Europe four to six.
  • Lumber procurement: 7 to 12 days. Longer for wide-format boards above 300mm and for FSC-certified stock, which is bought against certificate-controlled batches rather than open market lots.
  • Kiln drying: 12 to 18 days. Acacia is typically dried to 8 to 12 percent moisture content for export. This is the single least compressible stage in the whole chain.
  • Machining, sanding and assembly: 12 to 20 days. Driven by SKU count rather than total volume. Eight SKUs in one container take materially longer than two.
  • Finishing and curing: 5 to 8 days. Food-safe oil and beeswax finishes need genuine curing time before packing, or the cartons absorb residue.
  • Branding and packaging: 4 to 7 days. Laser engraving, hangtags, sleeves, retail cartons and barcode application.
  • Inspection and container loading: 3 to 5 days. Third-party inspection needs to be booked a week ahead in peak season, not the day the goods are ready.

Added up, that is roughly 50 to 70 days from deposit to goods ready for a first order, and 35 to 50 days for a repeat order. Any supplier quoting 25 days for a first container of mixed wooden kitchenware is either holding finished stock, subcontracting without telling you, or planning to explain a delay later. Our guide to moisture content and kiln drying standards explains why the drying block cannot be shortened without warping and cracking downstream.

Tet Is Not a Holiday. It Is a Capacity Cliff

Lunar New Year falls on 6 February 2027. The official public holiday is short, but that number describes government offices, not woodworking factories in Binh Duong, Dong Nai and Binh Dinh.

Wooden kitchenware production depends heavily on migrant workers from central and northern provinces. They travel home for one to two weeks either side of the holiday, and a meaningful share do not return to the same employer. The practical effect on a factory calendar is consistent year after year.

  • Mid-January 2027 onward: output begins tapering as workers take staggered leave and overtime becomes difficult to staff.
  • Roughly 30 January to 14 February 2027: effective shutdown. Machining stops, kilns are unloaded and not recharged, offices run on skeleton cover.
  • Mid-February to early March 2027: ramp-up. Headcount returns gradually, new hires need training, and first-pass quality is measurably weaker in the first two weeks back.

Counting conservatively, that is four to six weeks of lost or degraded capacity inside Q1 2027. Ports and customs brokers slow at the same time, so even goods finished before the holiday can sit waiting for a booking.

Why August Is the Decision Point, Not October

Work backwards from the two dates that matter to most buyers and the arithmetic settles the argument quickly.

For Q4 2026 retail. A Gulf or European retailer wanting stock on shelf in late November needs goods in its own warehouse by early November. Working back through 30 to 35 days of ocean transit to North European base ports, or 18 to 22 days to Jebel Ali, plus a week of destination clearance and inland movement, goods must be ready at the factory by late September. With a 50 to 70 day first-order lead time, the deposit needed to be paid in July and is already tight in the second half of August.

For Q1 2027 programmes. Anything that must land before the end of March 2027 has to be produced before the Tet shutdown begins, because the post-holiday ramp-up will not deliver a container in four weeks. That means goods ready by mid-January 2027, deposit and approved artwork by early November 2026, and capacity reserved with the factory well before that.

The factories that will still quote a comfortable date in October are usually the ones with unsold capacity, which is rarely a good sign in a peak season. The ones you actually want are booking their December and January slots now.

Material Choice Changes the Calendar

Lead time is not a property of the factory alone. It is a property of the material you specified.

  • Rubberwood. Widely available as a by-product of plantation latex cycles, finger-jointed panels are effectively a stock item. Shortest and most stable lead time of the three.
  • Acacia. Plantation-grown and abundant, but wide, clean solid boards are the constrained grade. Expect the procurement block to stretch when your specification calls for single-piece boards above 300mm wide with tight grain-matching.
  • Bamboo. Most laminated bamboo blanks are pressed on their own production cycle, and specifying certified or particular-density stock can add a week before machining even begins.
  • FSC-certified material of any species. Add 5 to 10 days. Certified batches are bought under chain-of-custody control and cannot be substituted from open stock mid-run.

If your programme is date-critical rather than specification-critical, discussing material substitution early is usually worth more than negotiating price. Our acacia, rubberwood and bamboo comparison sets out where each species genuinely performs. Buyers sourcing certified material should read the FSC chain-of-custody framework before assuming a certificate transfers between suppliers.

SKU Count Drives Lead Time More Than Volume Does

A common planning error is to assume that doubling quantity doubles the time. In wooden kitchenware it usually does not. Machining setup, jig changes, sanding profiles and finishing batches are organised per SKU, so an order of 4,000 pieces across two references often finishes faster than 2,500 pieces across nine.

Three practical consequences follow. First, consolidating a launch range into fewer references buys real weeks. Second, if a range must stay broad, split it across two shipments and produce the high-volume core first. Third, be careful with assortment cartons: mixed retail-ready packs require every component finished before any carton can close, so the slowest SKU sets the ship date for the whole container.

Branding decisions carry the same effect. Deep laser engraving, multi-position marking and individually printed sleeves each add handling time per piece. The trade-offs are covered in our private label and custom branding guide.

Ocean Freight: The Booking Window Is Part of Your Lead Time

Goods ready is not a shipping date. In peak season out of Cat Lai and Hai Phong, space on the stronger direct services needs to be booked two to three weeks before the cut-off, and rolled containers are a normal occurrence rather than an exception when bookings are made late.

Indicative port-to-port transit times from southern Vietnam, before destination handling, run roughly as follows: Singapore and Port Klang 5 to 8 days; Busan 10 to 12 days; Nhava Sheva and Chennai 12 to 16 days; Jebel Ali 18 to 22 days; Jeddah 20 to 25 days; North European base ports 30 to 35 days. Add a week for destination clearance and inland delivery, and more where routings avoid the Red Sea.

Rates and schedule reliability both move, so buyers planning a Q4 or Q1 programme should be checking a published benchmark such as the Drewry World Container Index rather than last year’s freight assumption, and reviewing the structural picture in UNCTAD’s Review of Maritime Transport. Where freight is inside your unit cost, the mechanics are set out in our FOB price and landed cost guide.

What Actually Makes a Lead Time Slip

In our experience the causes are predictable, and roughly half of them sit on the buyer’s side of the table.

  • Late artwork and file approvals. The most common single cause. A five-day delay approving an engraving file is a five-day delay to the container, because the slot behind you is already allocated.
  • Specification changes after deposit. Changing a board thickness or a finish after lumber has been cut restarts the material block, not the machining block.
  • Pre-production sample sign-off treated casually. Factories will not start bulk without it, and a sample sitting unapproved in a buyer’s office for a week is a week lost.
  • Inspection booked too late. Third-party inspectors in Vietnam are fully booked in October and November. Book the window when you confirm the order, not when the goods are ready.
  • Humidity and rain in the drying season. The southern wet season through to October slows air drying and increases kiln loading. Good factories plan for it; optimistic ones do not.
  • Compliance documents left to the end. Fumigation, ISPM 15 pallet treatment, certificate of origin and food-contact declarations all have their own issuing time.

The controllable half is process, and it is worth insisting on: a written production schedule with dated milestones, a named approval owner on your side, and weekly photo updates against the schedule rather than on request. Inspection planning is covered in more depth in our quality control and pre-shipment inspection guide.

A Planning Calendar You Can Work Backwards From

For buyers running a normal wholesale or retail cycle, the following backward schedule holds up well for wooden kitchenware and houseware out of Vietnam.

  • Target: goods on shelf. Subtract 2 to 4 weeks for your own warehousing, quality check and distribution.
  • Target: goods in your warehouse. Subtract 1 week destination clearance and inland transport.
  • Target: vessel arrival. Subtract port-to-port transit for your lane.
  • Target: on board vessel. Subtract 7 to 10 days for booking, trucking to port and cut-off.
  • Target: goods ready at factory. Subtract 35 to 50 days for a repeat order or 50 to 70 days for a first order.
  • Target: deposit and approved artwork. This is your real deadline. Everything before it is negotiation.
  • Add the Tet allowance. If any part of the production window touches mid-January to early March 2027, add four weeks.

Contract Terms That Protect the Date

Lead time is only as reliable as what is written down. Four clauses do most of the work.

First, define the start date explicitly as the later of cleared deposit and written approval of the final sample and artwork, so neither side can argue about when the clock started. Second, define goods ready as passing the agreed inspection standard, not as production being finished, which removes the incentive to declare readiness ahead of quality. Third, agree a booking responsibility and a named forwarder in writing, including who pays for a rolled container. Fourth, keep any late-delivery remedy proportionate and tied to a clearly documented cause; punitive penalties tend to produce optimistic quotations rather than reliable ones.

Frequently Asked Questions

How far ahead should I book capacity for Tet 2027?

Confirm your order with deposit and approved artwork by early November 2026 if the goods must be ready before the shutdown. Factories allocate January slots through November, and by December the realistic answer for most buyers becomes March delivery.

Can a factory shorten lead time if I pay a premium?

Partly. Overtime and priority scheduling can compress machining, finishing and packing, which realistically recovers one to two weeks. Kiln drying and material procurement cannot be bought forward, so a premium never buys back the full calendar.

Is a repeat order really faster, or is that a sales line?

It is genuinely faster. Sampling, artwork approval, jig setup and packaging origination are all removed, and the factory already knows the defect profile of the item. Fifteen to twenty days of the first-order schedule typically disappears on the second run.

Should I split one large order across two shipments?

Often yes, particularly for a launch. Producing the core high-volume references first lets you ship, sell and get market feedback while the long-tail SKUs are still in production, and it removes the risk of one slow item holding an entire container.

What lead time should I expect for compostable and disposable tableware?

Different profile entirely. There is no kiln drying, so material and moulding drive the schedule, and lead times are typically 30 to 45 days for established items. Certification and PFAS documentation, however, need to be resolved before production rather than alongside it.

Where Viet Farm Vision Fits

Viet Farm Vision is a Vietnam-based OEM manufacturer and exporter of wooden kitchenware and houseware, compostable and disposable tableware, agricultural products and handcrafts, supplying wholesale and private-label buyers across the Middle East, Asia and wider international markets.

On scheduling specifically, we quote lead time in two separate parts, days from deposit to goods ready and days from goods ready to on-board vessel, and we issue a dated production schedule with the proforma invoice rather than after the deposit. Buyers receive weekly progress against that schedule, and we flag material procurement or drying constraints at quotation stage instead of explaining them later. For programmes touching the Lunar New Year window, we confirm capacity allocation in writing before the deposit is requested.

If you are planning a Q4 2026 or Q1 2027 wooden kitchenware, houseware or compostable tableware programme, send us the target on-shelf date and the destination port and we will work the calendar backwards with you before you commit to a specification.
